Inflection Point Engineering Section 4 — Structures and Foundations

Roadways and Paving

IPE Engineering Practice IPE-EP-4-4-1

Document number: IPE-EP-4-4-1 · Section: 4 — Structures and Foundations

SCOPE

2.0 REFERENCES

The latest edition of the following publications are referred to herein.

STANDARDS AND PUBLICATIONS

IPE Engineering Practices
EP 1-1-3 Deviations to IPE Engineering Practices S&L EP 3-1-1 P Philosophy
EP 4-1-1 Design Criteria and Loads for Structures EP 4-2-1 Foundation Types and Selection Criteria EP 4-2-2 Earthwork
EP 4-3-1 Concrete Design
ACI Standard
318 Building Code Requirements for Reinforced Concrete
APWA
Standard Specifications for Road, Bridge and Municipal Construction
ASTM Standards
A185 Specification for Steel Welded Wire, Fabric, Plain, for Concrete Reinforcement A615 Deformed and Plain Billet - Steel Bars for Concrete Reinforcement
C94 Ready Mix Concrete
D1557 Moisture-Unit Weight Relations of Soils, and Soil Aggregate Mixtures Using 10-lb. Rammer and 18-in. Drop.

3.0

3.1

3.2

3.3

3.4

3.5

3.6

3.7

3.8

4.0

4.1

4.2

4.3

4.4

4.5

4.6

4.7

5.0

5.1

DEFINITIONS

Base Course - Intermediate foundation material for roadways. Base Course usually consists of stone or mineral aggregate and is placed on top of the subgrade.

Contractor - Company or business that agrees to furnish materials or perform specified services at a specified price and/or rate to the Owner.

Inspector - A Inflection Point Engineering, LLC appointed engineer or inspector. Owner - Inflection Point Engineering, LLC .

Owner's Engineer - A Inflection Point Engineering, LLC appointed engineer.

Prime Coat Material - Liquid asphalt applied to the surface of placed and compacted base course material in preparation for receiving the final surface course.

Subgrade - Existing soil after excavation. Soil conditions on which Base Course is to be applied. Surface Course - Final hot-mix asphalt concrete surface.

MATERIALS OF CONSTRUCTION

Subgrade Repair Material shall conform to APWA gravel base compacted into a hard, dense mass in accordance with EP 4-2-2.

Base Course shall be stone or mineral aggregate, conforming APWA gravel base. Aggregate base shall be Class 2, 1-1/2 inches maximum mineral aggregate.

Surface Course shall be Type B with 1/2 inch maximum coarse graded aggregate and shall conform to APWA Construction and Material Specifications.

Prime Coat Material shall be liquid asphalt, Grade RC-70 conforming to APWA Construction and Material Specifications.

Tack Coat Material shall be emulsified asphalt, Type MS-2 or SS-2 conforming to the APWA Construction and Material Specifications.

(*)Parking Bumpers shall be precast concrete, extra duty type, 6 feet. Bumpers shall be 3000 psi compressive strength concrete weighing approximately 265 lb each, gray or white as selected by Owner's Engineer. Bumpers shall have two (2) 1-inch diameter holes for anchoring pins and shall be reinforced with two (2) longitudinal #4 deformed bars, ASTM A615, Grade 60. Anchoring pins shall be #6 deformed bars, 3-feet long or equal.

(*)Traffic Marking Paint shall be Glidden 'Traffic Zone Paint" or Sherwin-Williams 'Pro-Mar" Series B36. The Owner's Engineer shall select the color.

PAVING AND ROADWORK DESIGN

Except as otherwise noted, concrete design shall be in accordance with ACI 318.

(*)Traffic Conditions

The road and pavement design shall conform to the maximum equipment wheel loads and traffic volumes specified by the Owner's Engineer. The requirements of this Practice shall be followed, unless otherwise specified. Drawings and specifications required for the design shall be submitted to the Owner's Engineer.

The thickness design shall take into account the quality of the subgrade soils. Appropriate tests shall be made to determine the conditions of in situ subgrade soils, see EP 4-2-1.

Roads shall be crowned (1 to 2 percent for concrete pavement and 2 to 4 percent for asphalt pavement) to provide adequate drainage.

Area paving for process units shall be sloped to drain within the pavement limits, but away from equipment or pipe racks.

SUBGRADE PREPARATION- ROADWAYS

Subgrade preparation shall consist of clearing, grubbing, excavation, embankment, dressing shaping, wetting, compaction, and stabilizing, as required. Such preparations shall be made to the full width of the road bed or plant yard in accordance with the grade, lines and cross sections shown on the drawing or plans, see EP 4-2-2 for further requirements for earthwork.

Excavation shall consist of excavating and grading the roadway or the plant site within the limits of grade stakes (including slope rounding and 'V" ditches or gutters paralleling the roadway or plant site). Also the disposal of excavated material and the formation of embankments, subgrade, shoulders, slopes, berms, and dikes is included as part of excavation operations.

Embankment shall consist of fills from acceptable materials excavated to the lines, grades, and cross sections shown on the construction plans, or as otherwise approved by the Owner's Engineer.

Stabilizing shall consist of a foundation course for surface courses or additional foundation courses, and shall be composed of materials constructed in conformity with the typical sections shown on the construction plans.

CONSTRUCTION REQUIREMENTS

Shoulders shall be constructed as shown on the construction drawings.

PAVING REPAIRS

QUALITY CONTROL

The surface of the completed work shall not contain irregularities in excess of 1/4 inch, when tested with a 10-foot straight edge.

10.0 TABLES

TABLE 1

DOCUMENTATION REQUIREMENTS FOR ROADWAYS AND PAVING per EP 4-4-1

Item Description Format As-Built
1 Drawings and specifications. See EP 2-5-2 Yes
2 Results of laboratory testing of paving materials. Text N/A
3 Field inspection and testing results. Text N/A

11.0 FIGURES

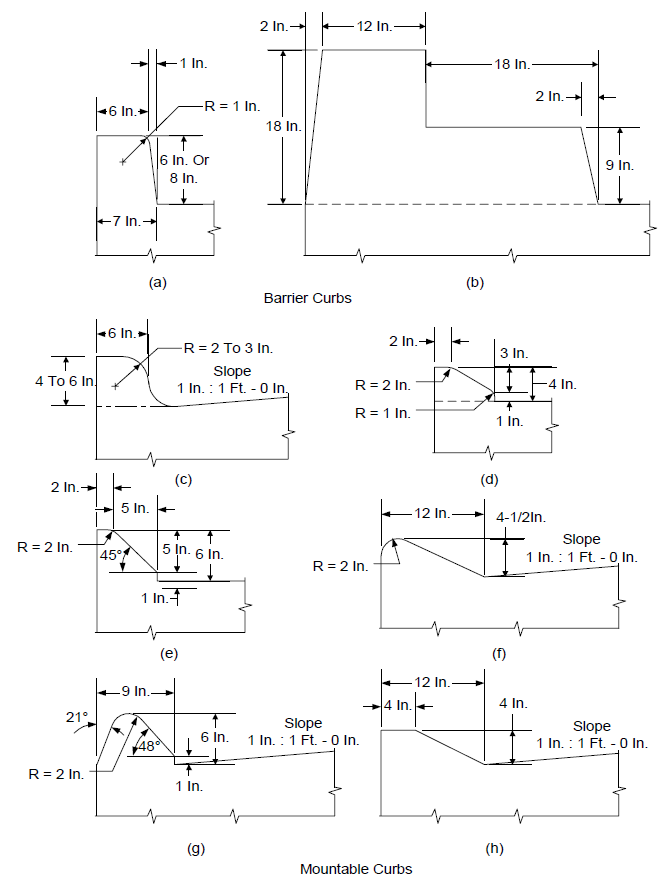

FIGURE 1 TYPICAL CURB DETAILS

Figure
